Installing a water main and sewer for a new construction project differs from replacing a water line or sewer line of an existing house. The process requires more time and attention to detail in order to obtain all of the required permits and receive DEP (Department of Environmental Protection) signoffs upon the completion of the installation.

SD 1&2
Harris Water Main and Sewer Contractors recently installed a new 6” combined (storm & sanitary flow in one pipe) sewer line and a new 2” combined (domestic and sprinkler feed in one pipe) water service for a house being built in Floral Park Queens. The process started with the project engineer and the project manager sketching and plotting the plans to be approved by DOB (Department of Buildings) for the new water line and sewer installation. The entire process from the architect being hired to work on the job, completing the drawings and having the plans approved, was completed within a 10 week period.
Harris Water could now begin working on obtaining all required permits now that they had all required approvals in hand. The engineer was also working on the SD 1 & 2 for the sewer, the Cross Connection Letter (AKA RPZ approval) for the combined water service and had these approved within a few weeks of DOB drawings. The project manager for Harris Water needed the SD 1 & 2, the cross connection letter, the DOB approved plans and the water meter application before he could submit any paperwork to DEP. After all of the paperwork was submitted to DEP it took one week before everything was approved and the water/sewer permits were issued. Harris now submitted all required paperwork to DOT (Department of Transportation) for street opening permits, which were released within three days of all paperwork being submitted. The project was ready to begin with a target completion date of three days.

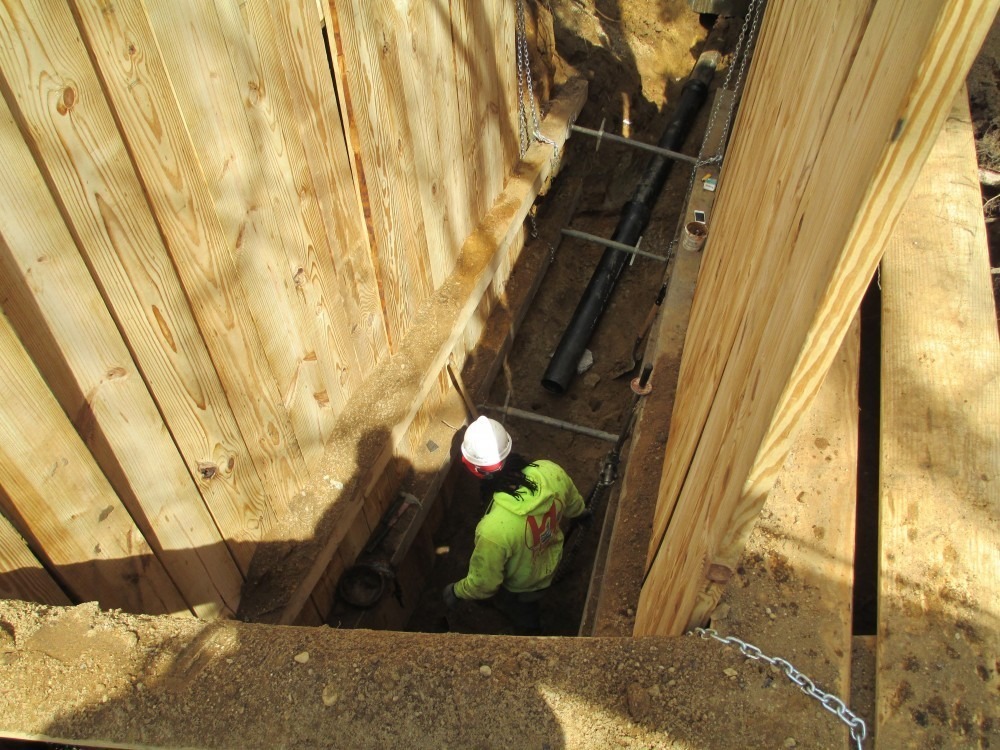

On this particular project the water main and sewer were located in two separate trenches on each end of the house which required additional excavation, labor and time to complete the installation. In many cases the sewer and water are located in a common trench where the sewer would be installed followed by the water line which is located above the sewer, this usually saves time resulting in a more cost effective price for the installation.

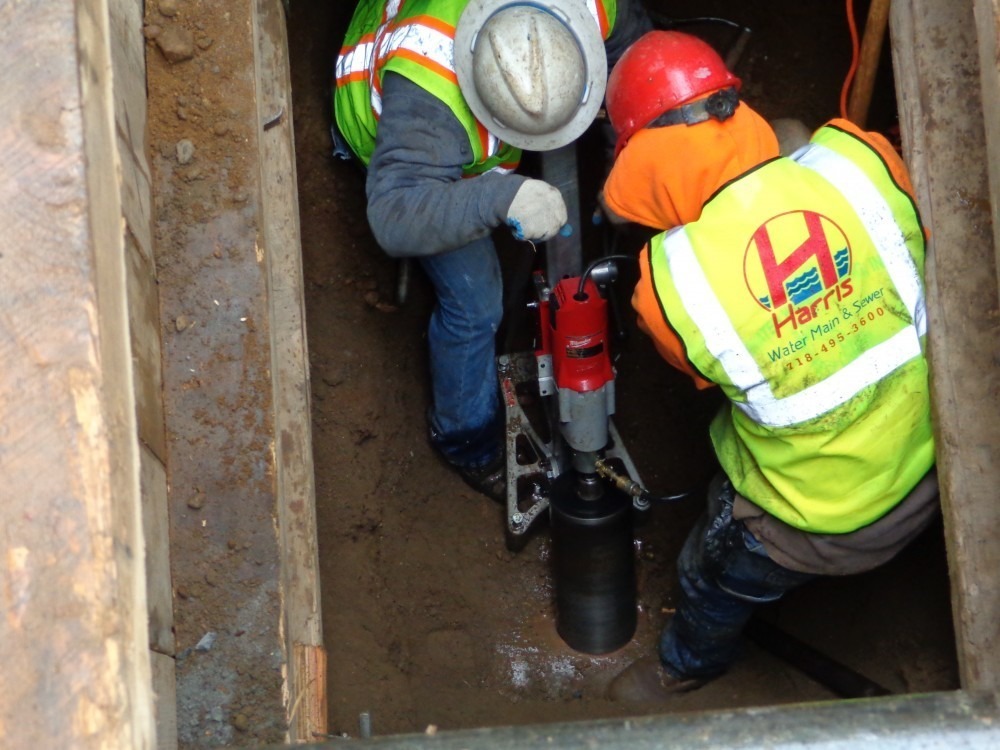

The new 2” combined water service was being installed approximately 10’ away from where the sewer line was being installed at the very same time. The DEP field crew was scheduled to be on-site to install the new 2” tap connection later that afternoon; at this point the new copper pipe is hooked-up to the tap connection and allowing the house to have running water feeding all bathrooms and the sprinkler system. Harris completed the water line installation with a curb valve on the sidewalk as per DEP requirements and a new OSY valve on the inside of the building.

The roadway and sidewalk were both resurfaced the next day and the project was completed leaving this Queens developer one step closer to having the new homeowners move into their dream house. DEP sign-offs were released within one week of the final inspection and given to the developer for his records.
